Construction-Project-Cornwall

Site Diary - 16th Century Farmhouse

Structural remediation, extension and deep retro-fit on a beautiful stone farmhouse in Nanstallon, Cornwall.

A collaborative approach

By working closely with the client, structural engineering team and architects STUDIO/gather, this very special project has been a truly collaborative approach from Day 1, as the original structure has been carefully revealed to inform structural and design decisions. Great care has been taken to preserve the character and integrity of the building throughout the process. With the demolition and structural remediation phase on the original structure undertaken over the first few months of 2026, we have now completed groundworks and are mid-framing on the large timber extension.

See below for monthly updates on progress.

March

In March, work on the lintel replacement continued, with the masonry team moving on to each new opening as the previous one cured.  At the same time, we removed a huge two storey section of the back wall, to make way for the groundworks ahead of the timber framed extension.  The wall removal required a significant amount of propping whilst structural steelwork was installed.  Once the steel install was completed, the masons could start work on making good the stonework on each side of the removed section of wall.

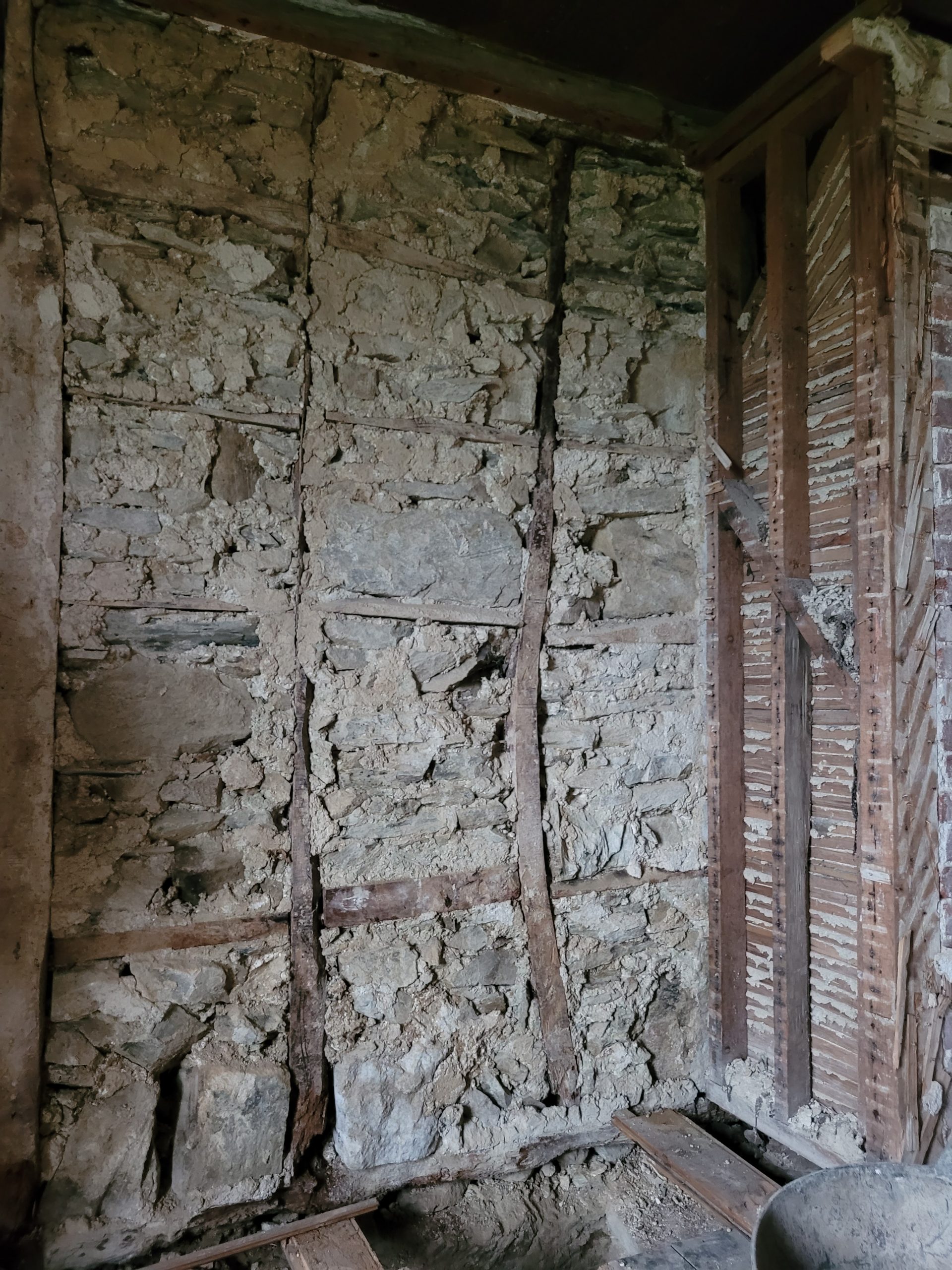

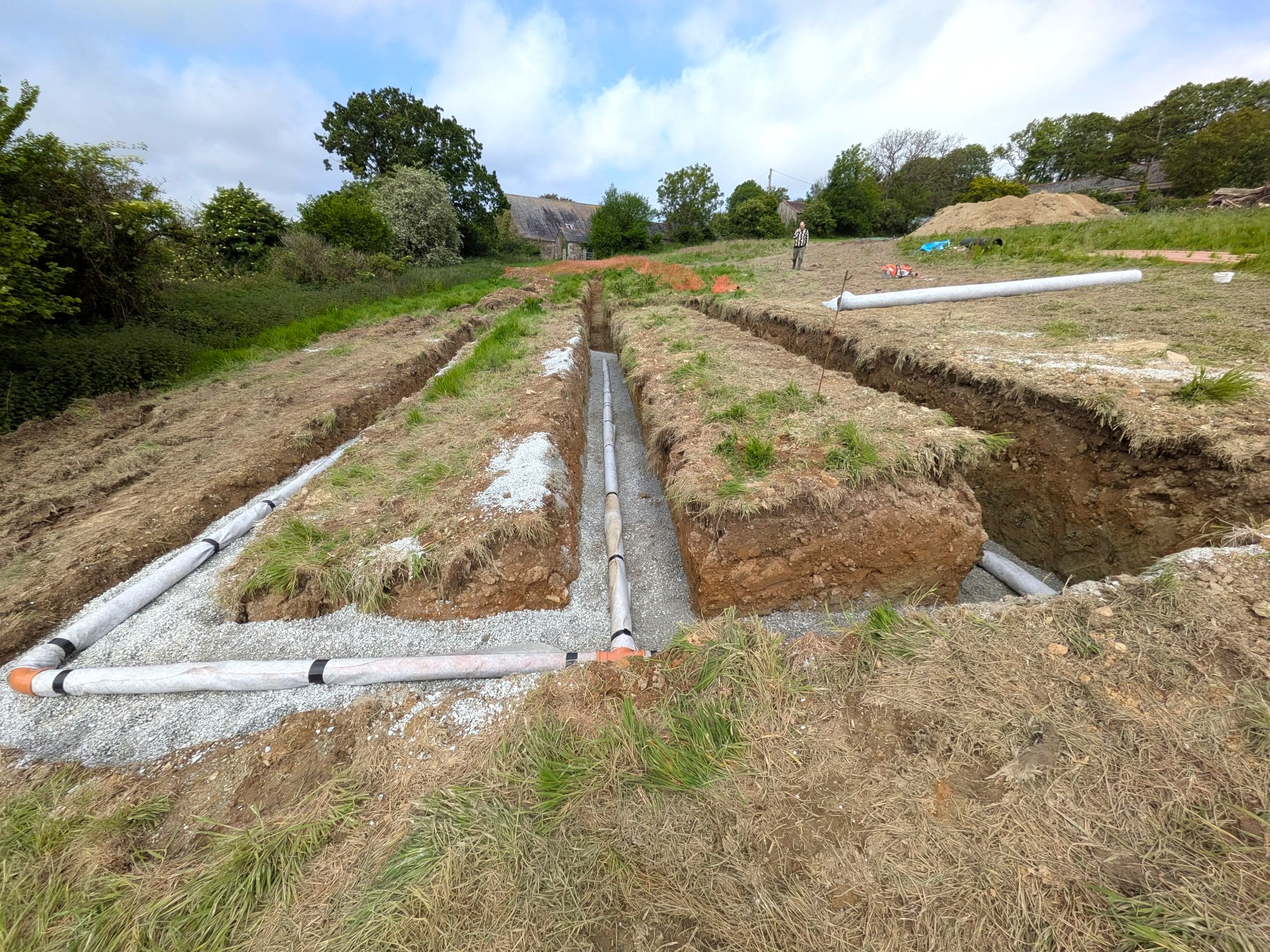

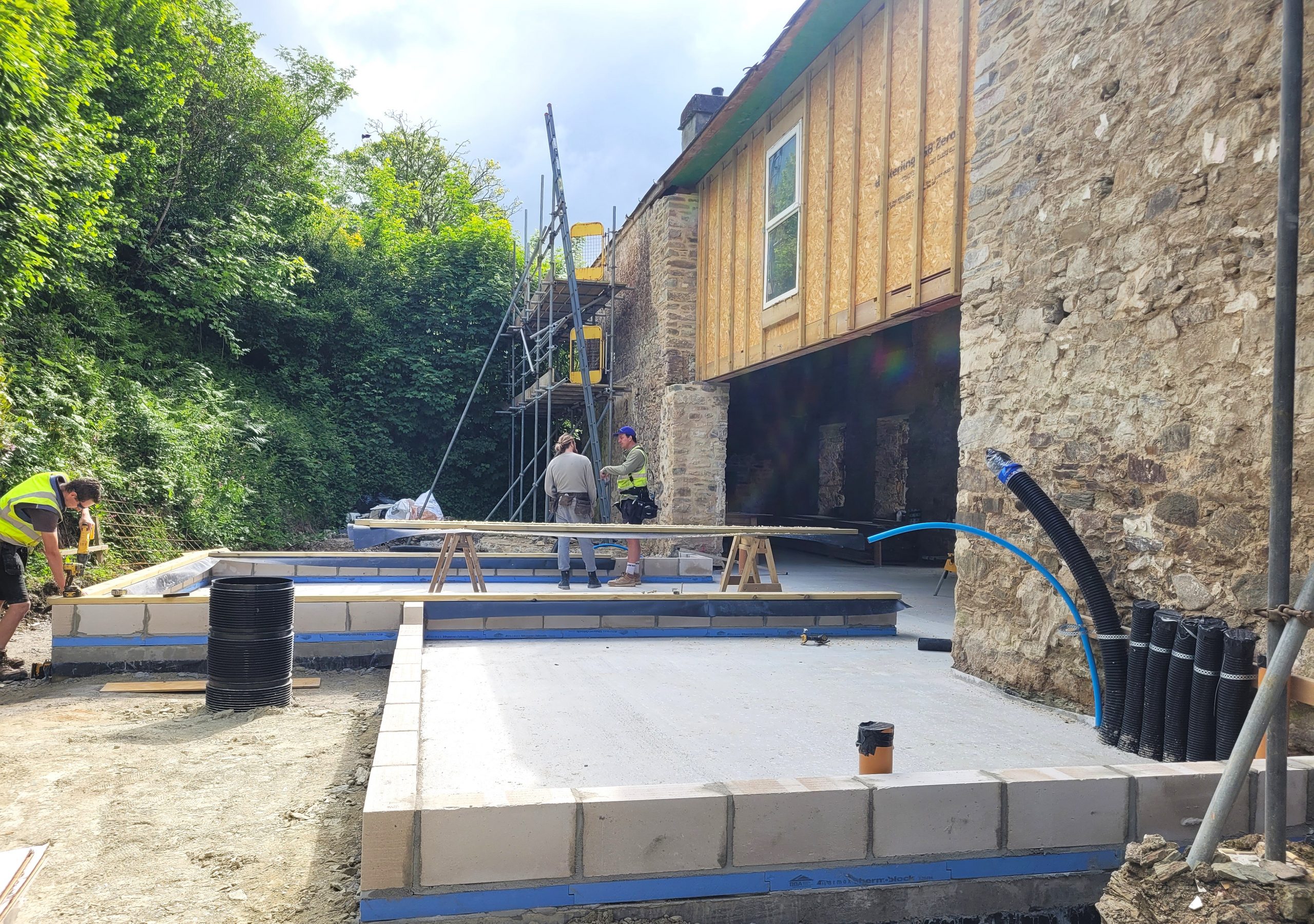

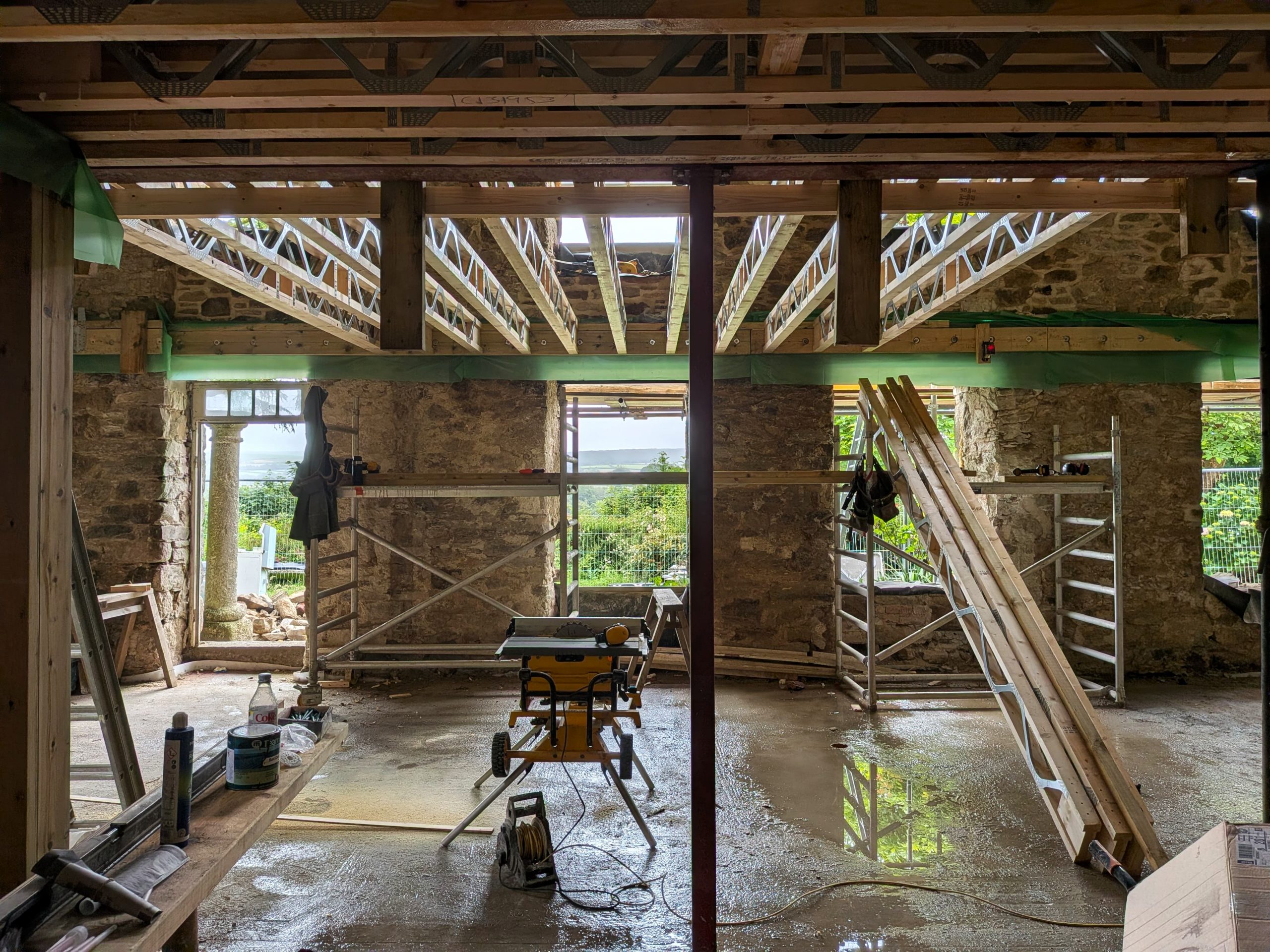

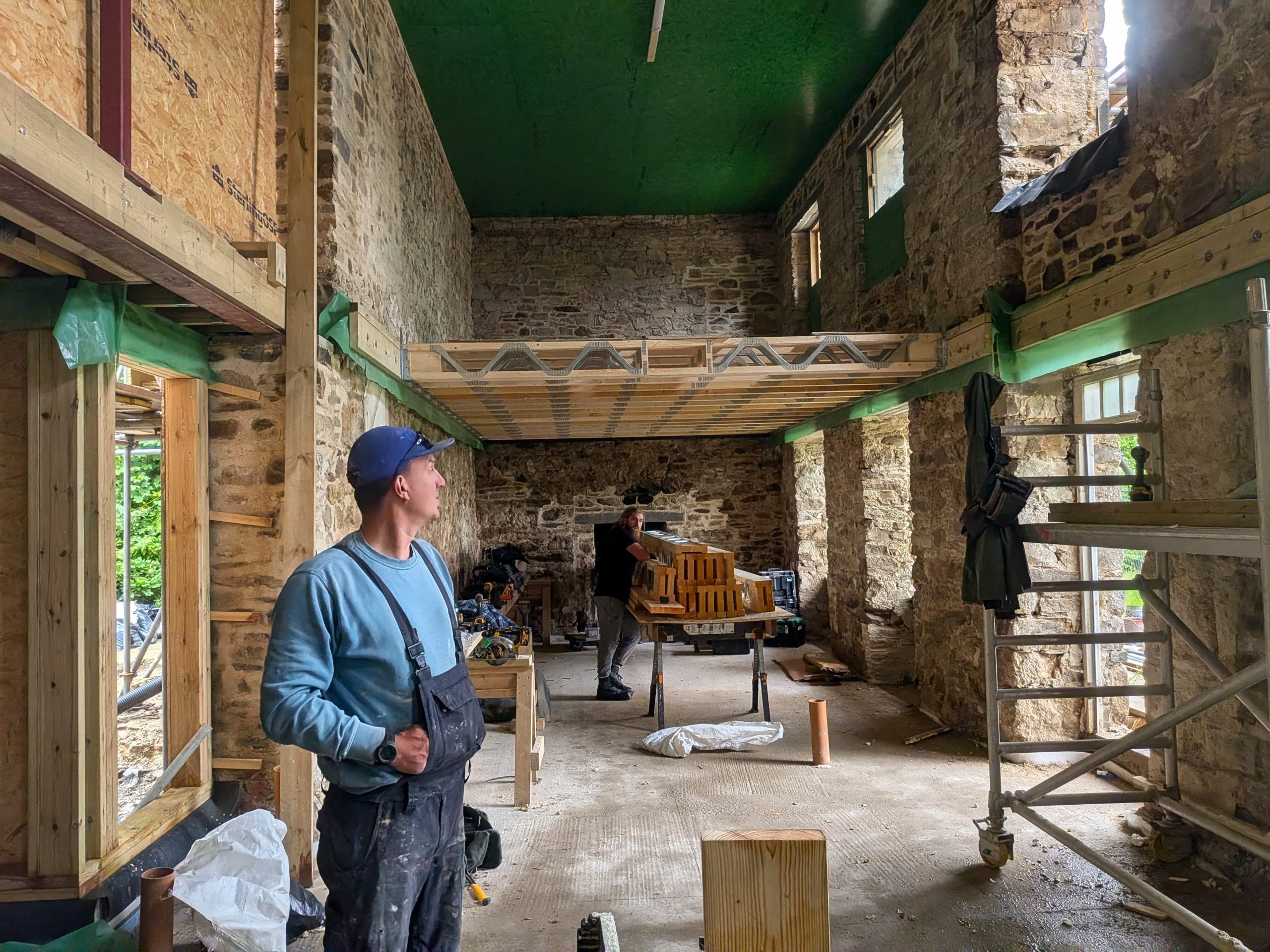

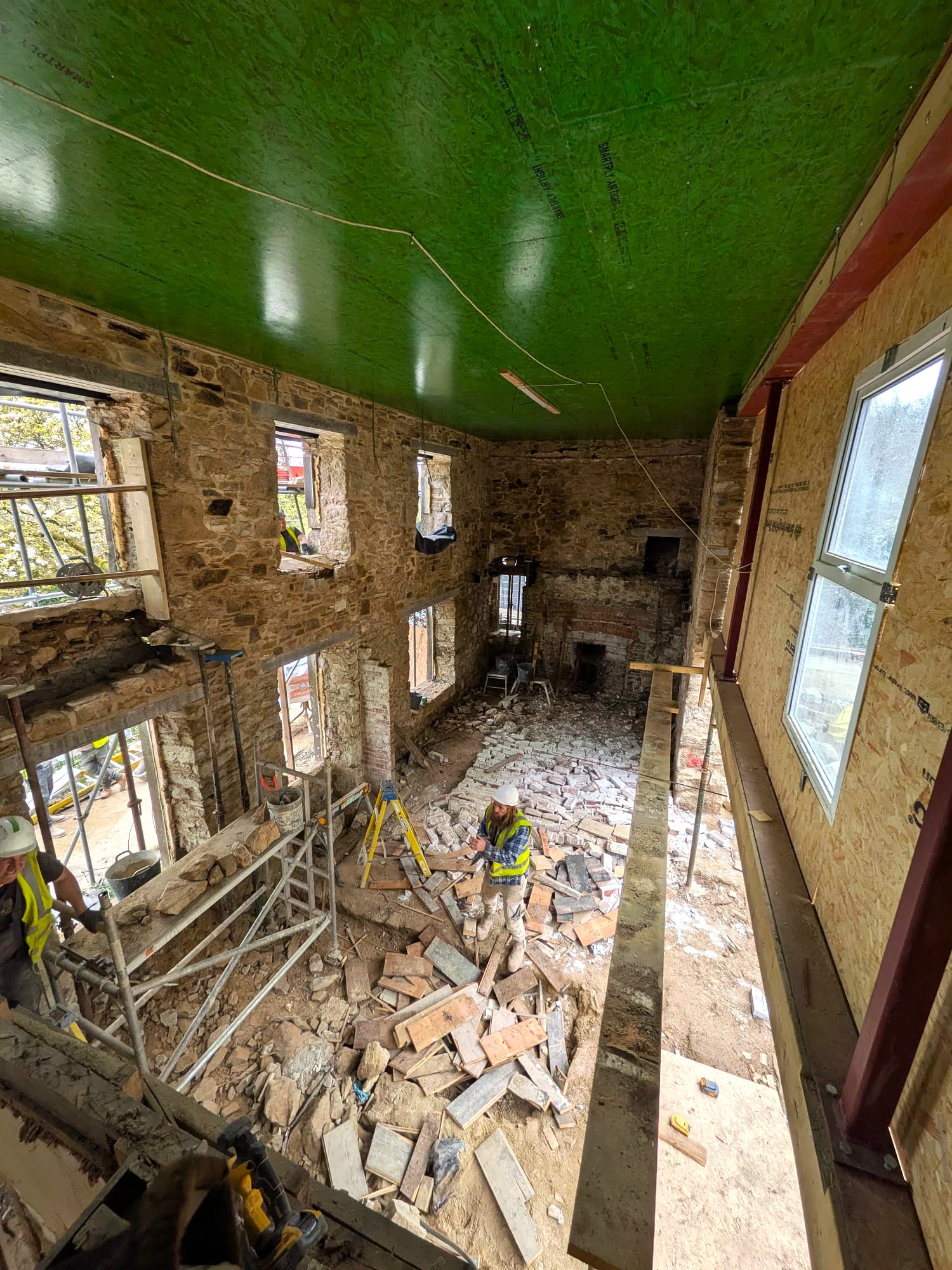

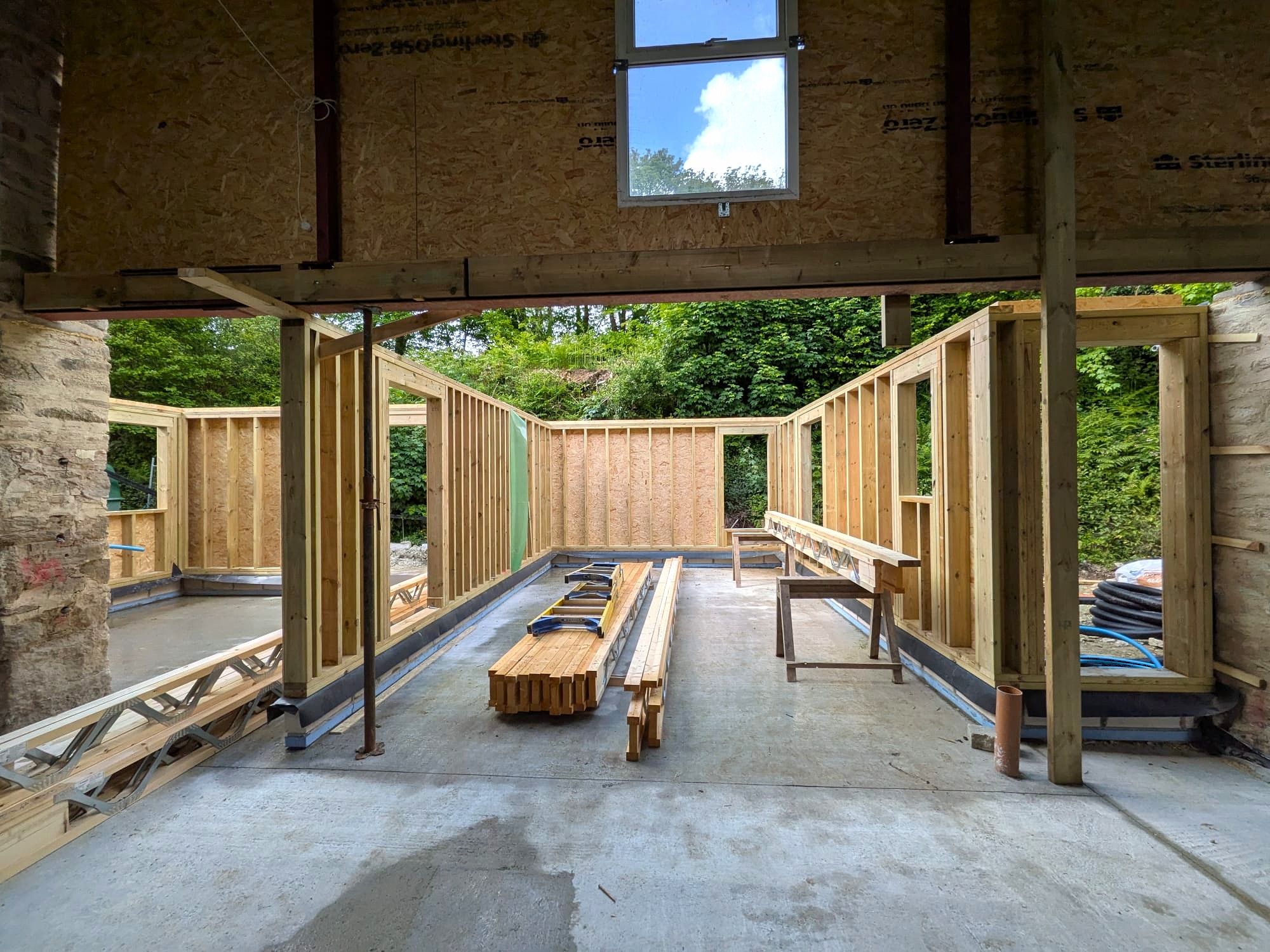

During this time, we also discovered that a small lean-to section of the original house would require more structural repair work than originally anticipated.  This section was originally going to be tied into the timber extension, but it became apparent that it would be more cost effective for it to be demolished and fully rebuilt in timber as part of the extension work.  We worked with the architects and S/E to adjust the design, and then proceeded with demolition and making good of the surrounding areas.

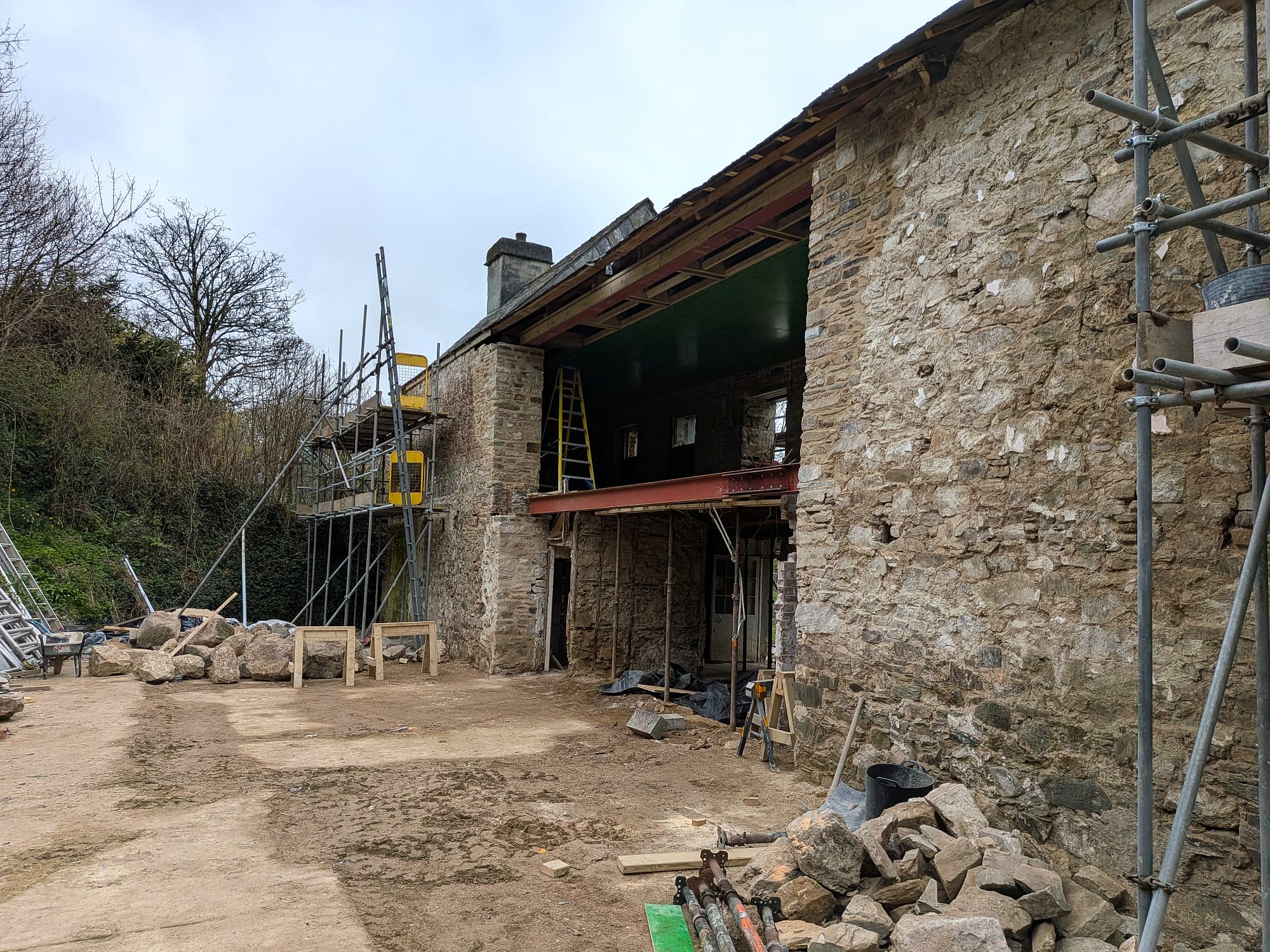

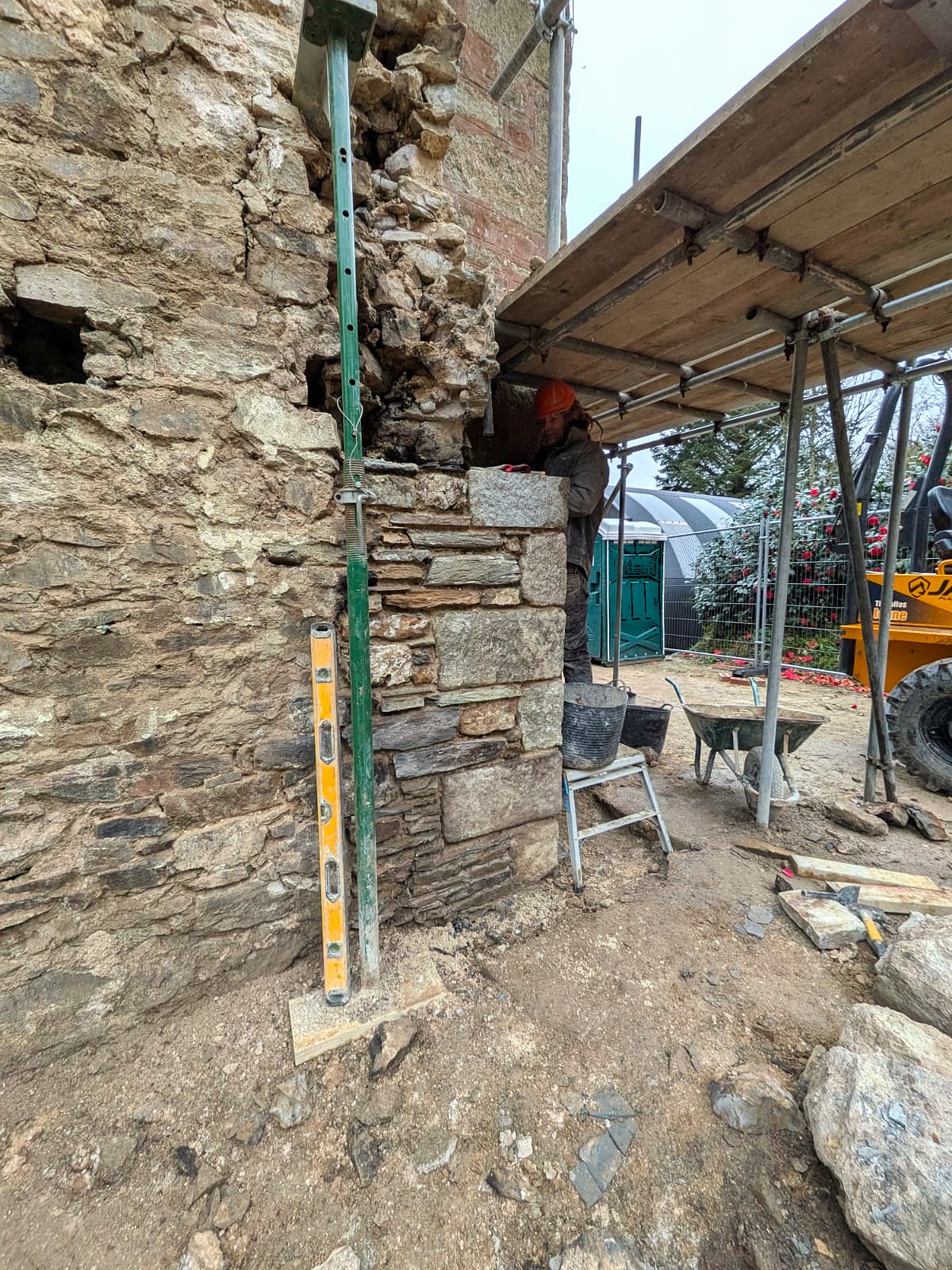

stone building with scaffolding

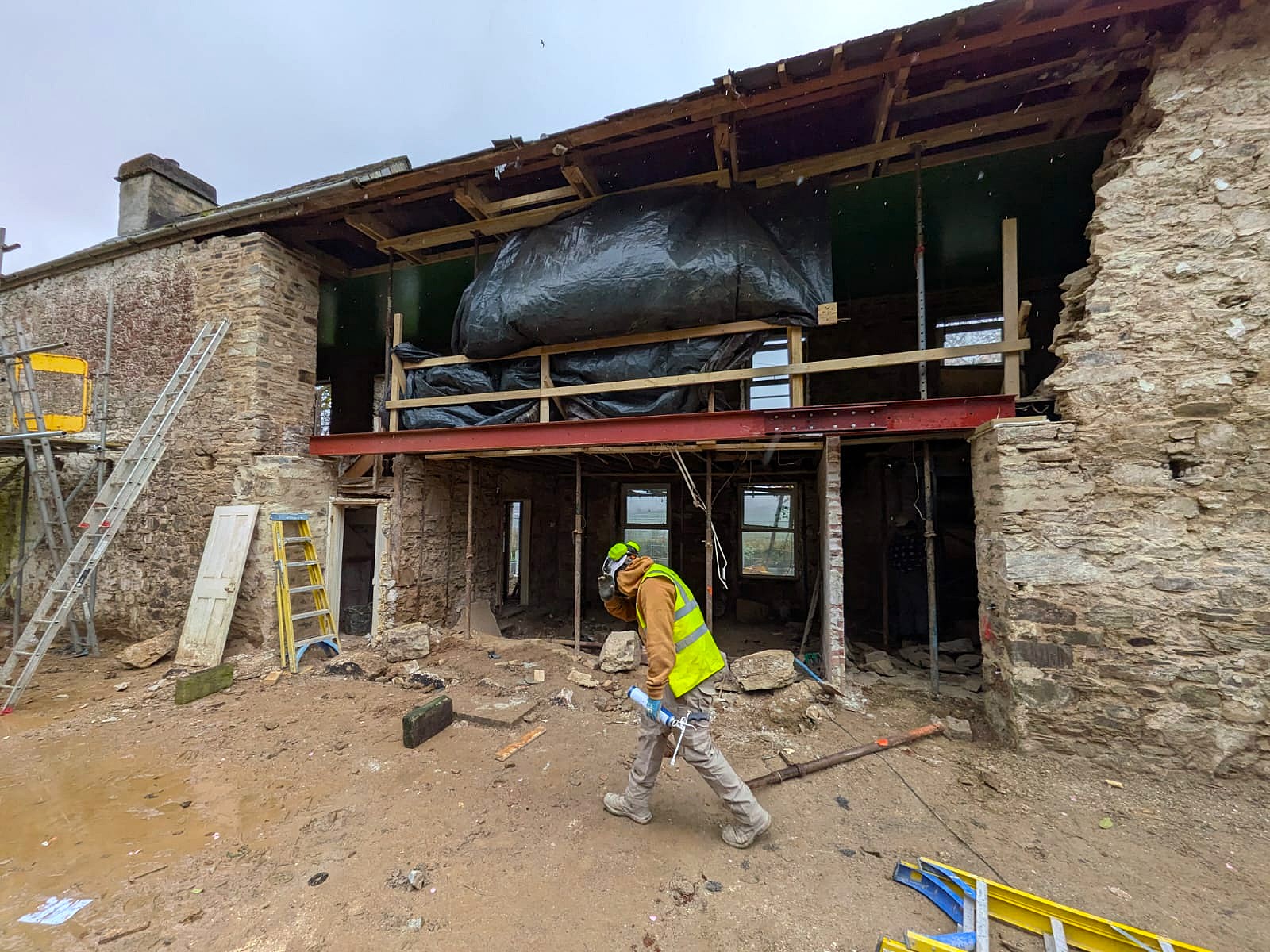

open second story building site
Stone Wall and Scaffolding

February

In February, the masons cracked on in earnest.  Every opening was propped with acros and needles, and the team made their way through over 70 new lintel installations (the walls are so thick that some openings are taking 6 or 7 new concrete lintels), and then built up the stonework back over each opening.  Each lintel replacement needed to remain propped for up to two weeks following the stonework build-up to allow the lime to dry.

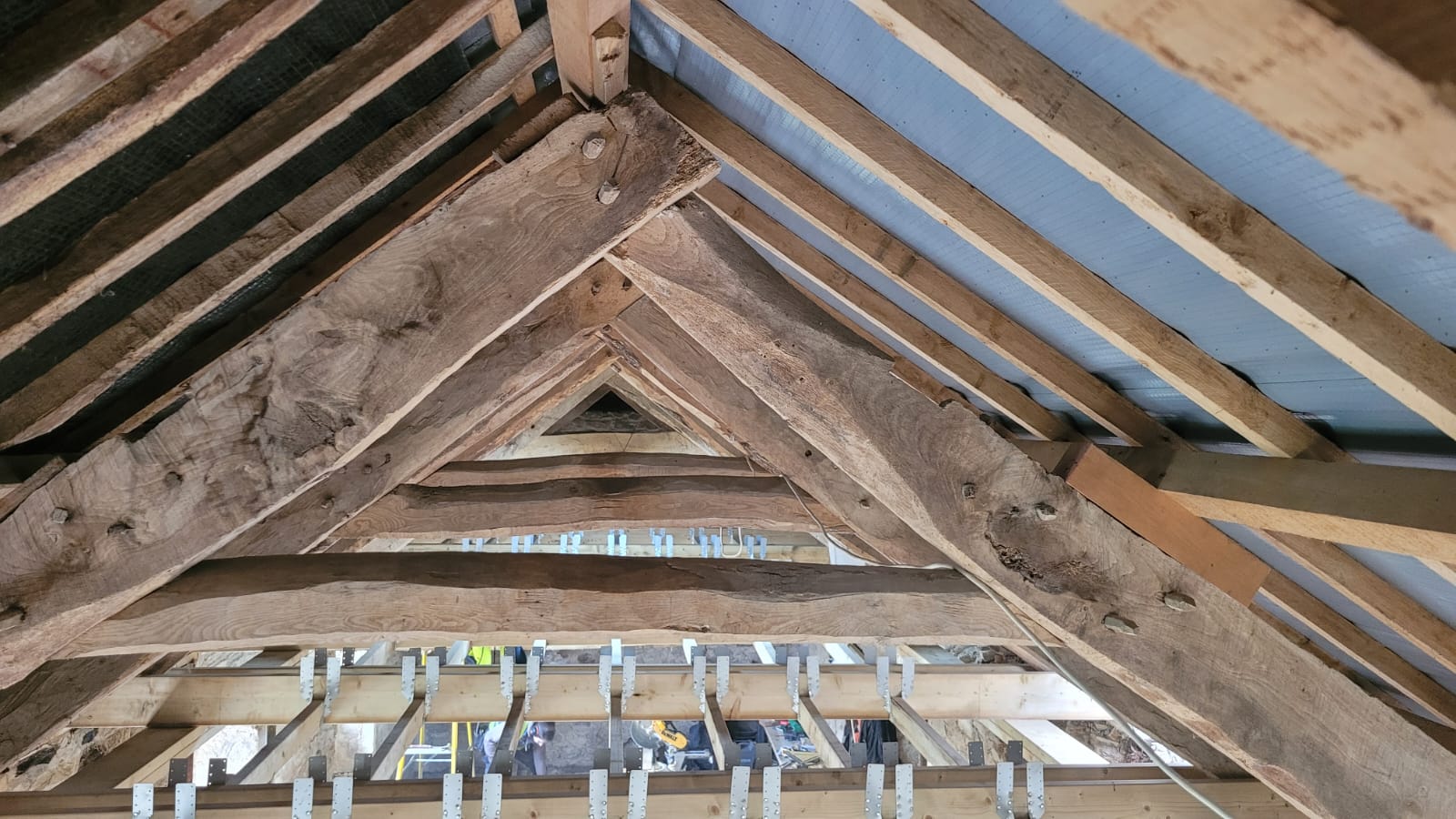

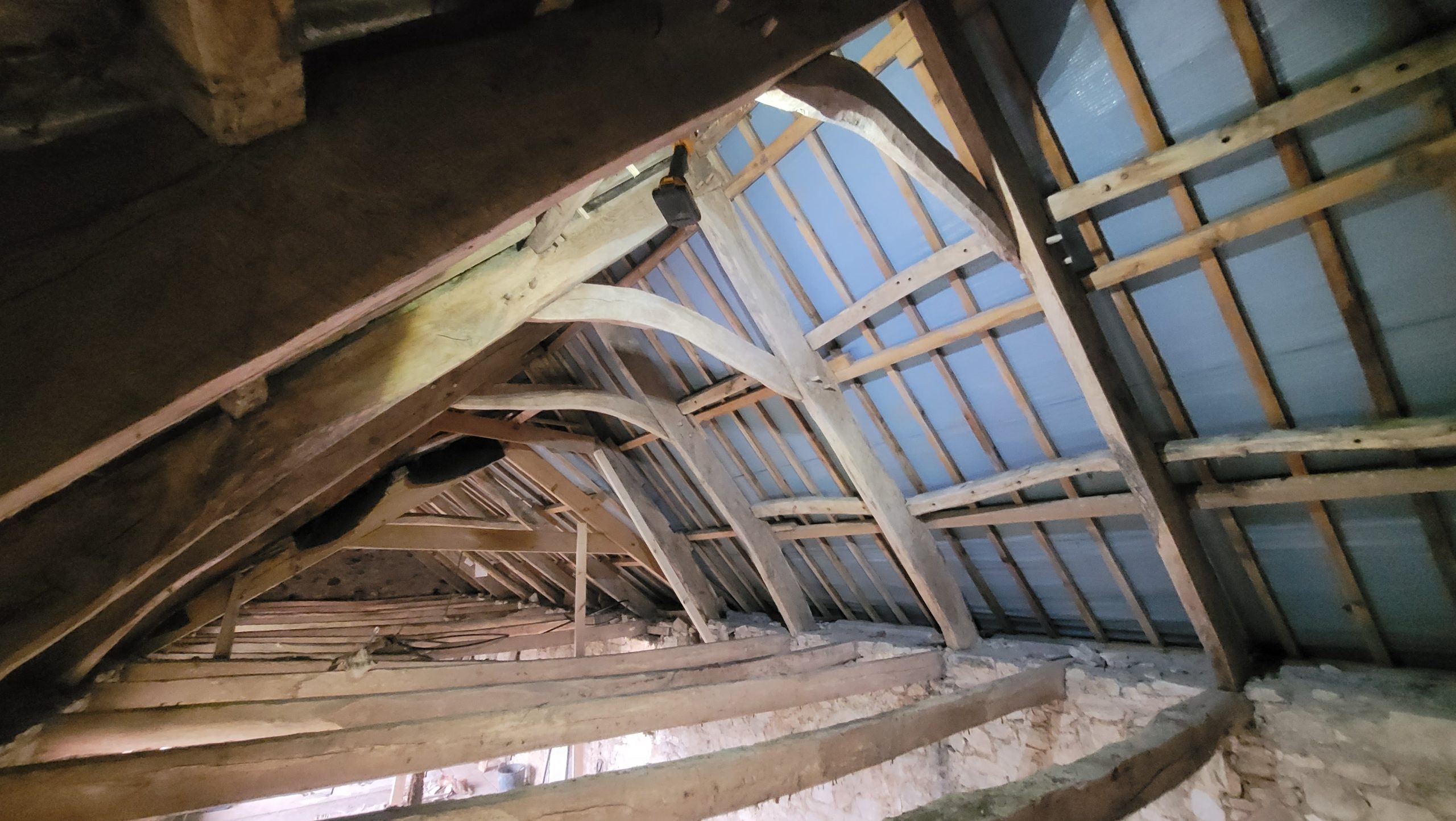

Alongside the masons, the carpentry team reinforced the existing roof trusses which were rotten at the wall plate where they met the stone wall, and installed new collar ties for the entire roof structure.  We needed to ensure that all structural remediation to the roof was completed before the end of April, including re-boarding the ceiling, as the presence of bats in the roof space would mean that we would be prohibited from undertaking any works to the roof between April and October.

January

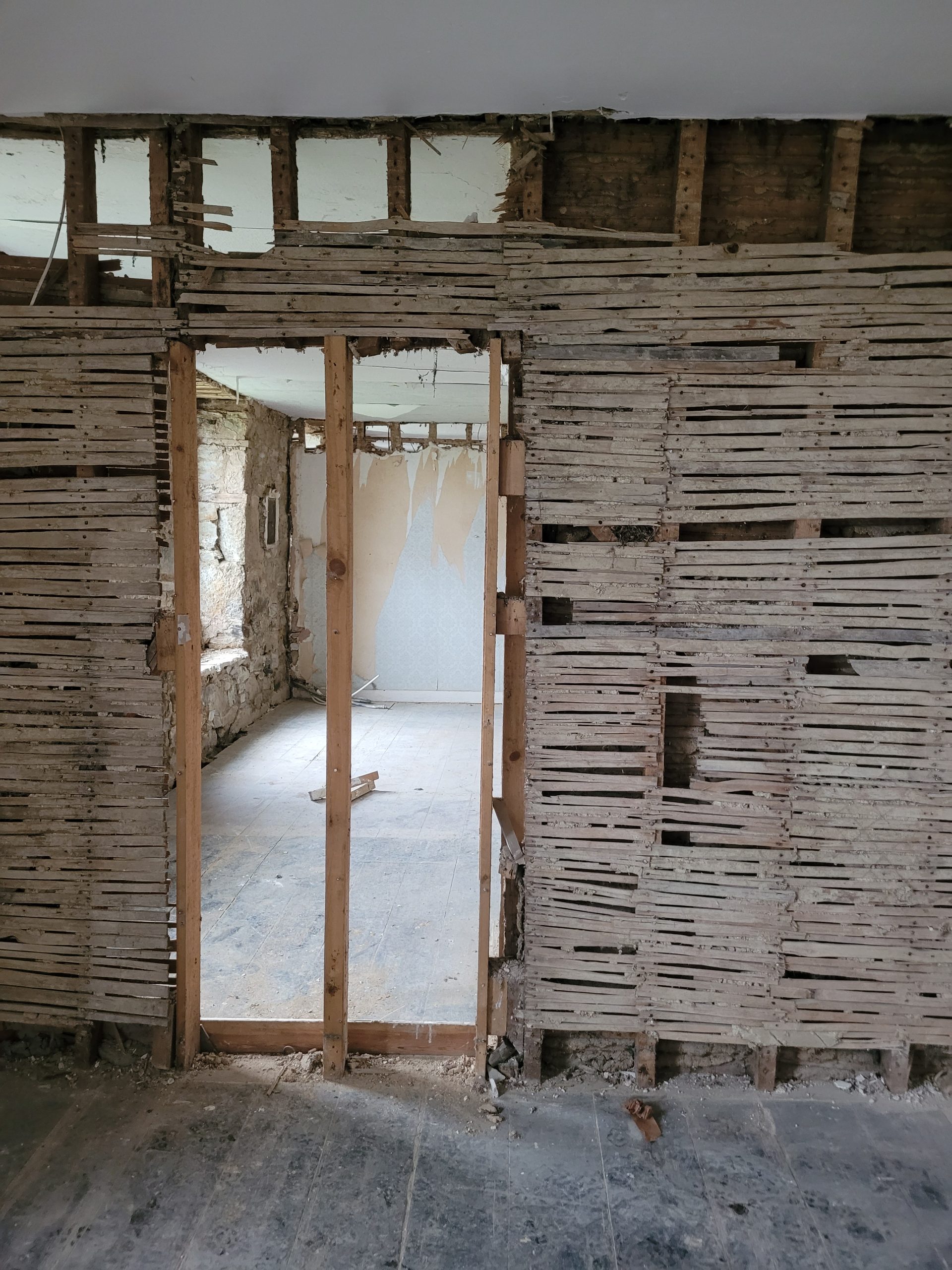

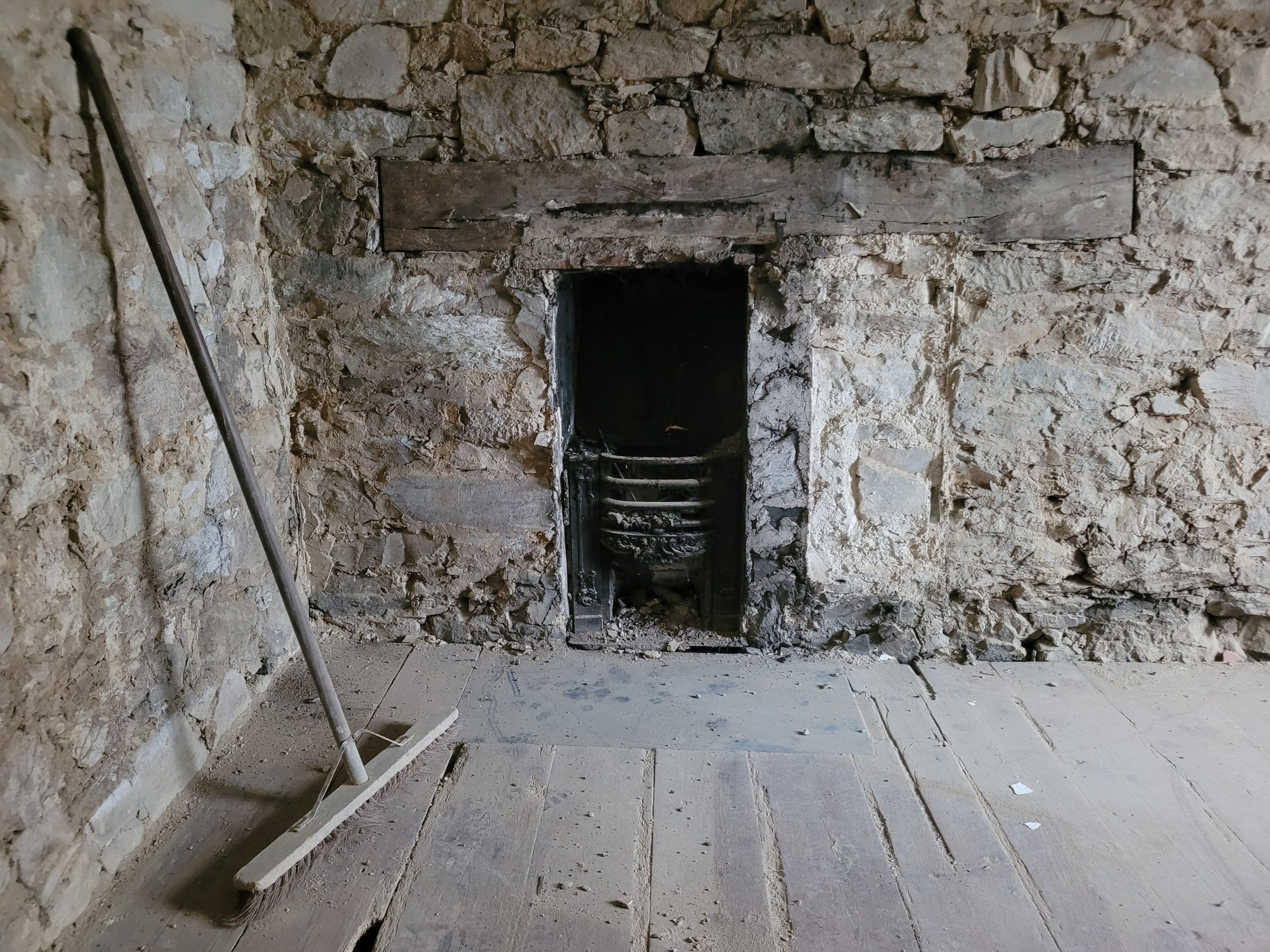

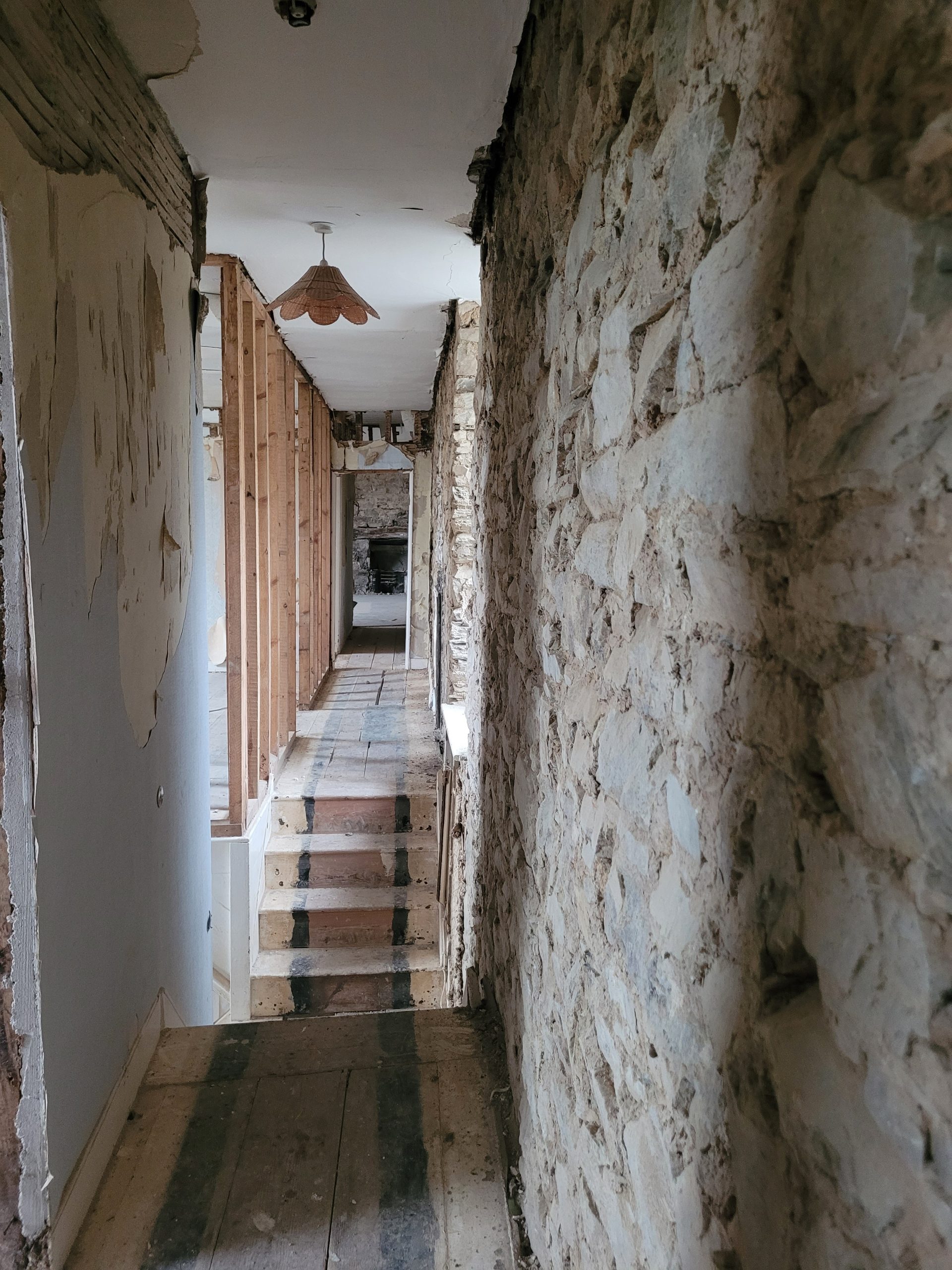

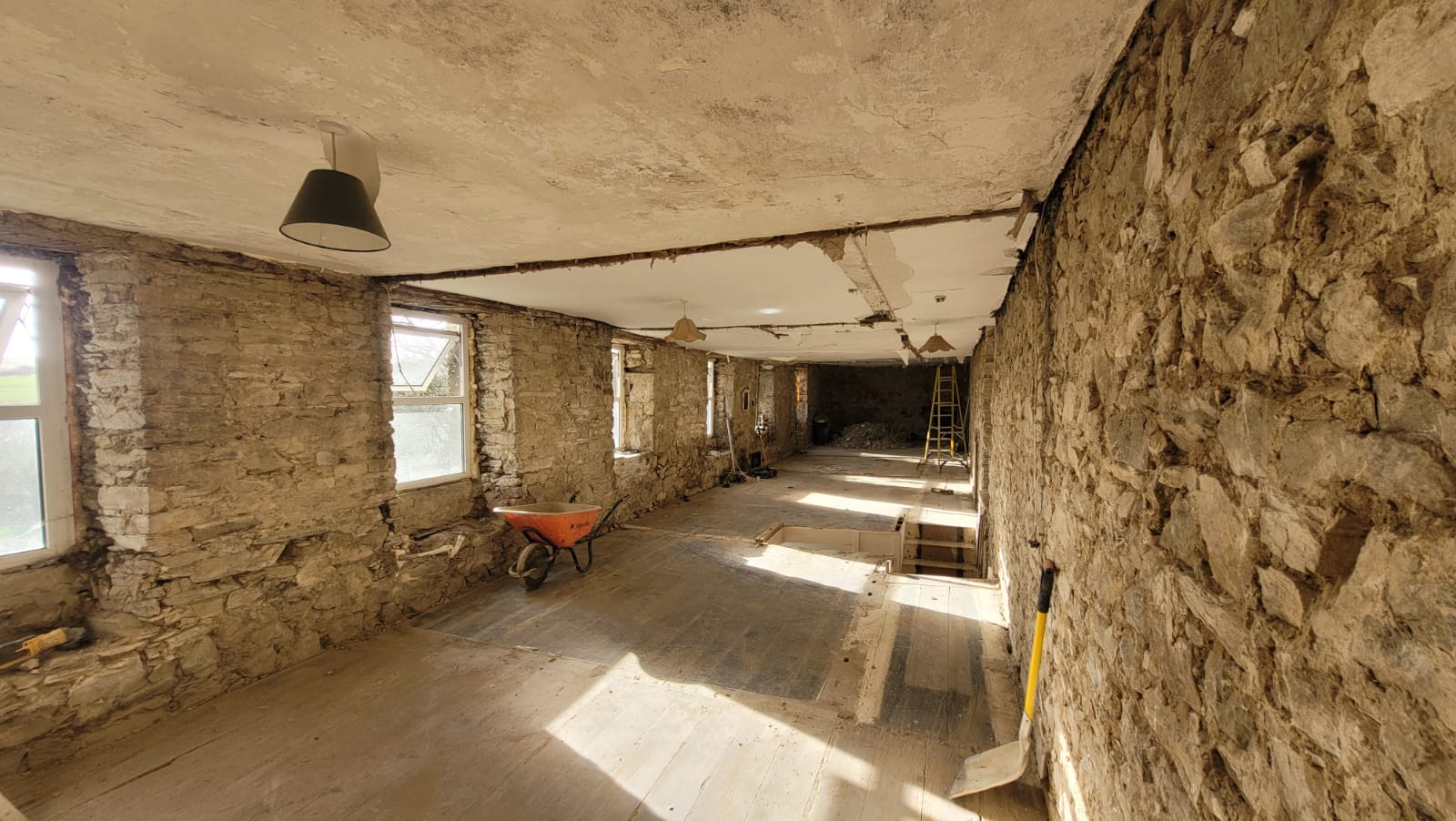

The first job on site at Nanstallon was an extensive strip out; opening up the building to allow the structural engineer access to assess the structural integrity of the building.  Areas that needed assessing included the general state of the stonework, the integrity of lintels spanning wall openings and the two enormous fireplaces at each end of the building.  Eventually, the first floor deck will also be removed in it’s entirety, but will be staying in situe until the remedial masonry on the first floor is completed.

We also demolished and removed a draughty single storey extension from the back of the building, to make way for a super insulated, dual-level timber framed extension.
